New horizontal split case high service pumps with a production capacity of 50 MGD. |
During heavy rain events, the water source has been susceptible to rapid and prolonged changes in quality, peaking as much as 10 times the average turbidity level. The ability to anticipate these changes in water quality provides plant staff an opportunity to set forth operational changes at the facility so that the finished water quality is not adversely affected.
Through coordination with the U.S. Geological Survey (USGS), Columbia was able to negotiate an agreement to make improvements to one of USGS's water-quality monitoring stations located upstream of the WTP's raw water intake. The existing station gathered data and periodically reported the information back to a database, which it would then upload to a website. As part of the project, improvements were made to the station to increase the sampling capabilities of the equipment and to establish threshold limits for specific water quality parameters that would trigger quicker reporting intervals.
Complex Challenges
Among the particularly complex project challenges that needed to be managed were:
- The age of the Canal WTP: The Canal WTP originated in 1906. Significant research, data collection and field verification were required to develop as-built plans for existing infrastructure and to produce an accurate basis from which to begin design.
- Isolation of valves for pipe replacement: A plan was developed in collaboration with WTP staff to identify operable valves that could be utilized in the detailed construction sequencing plans. Likewise, a plan to replace inoperable valves was also developed.
- Maintaining a minimum 50-MGD plant capacity throughout construction: A detailed sequence of construction documents was prepared, and temporary high-service and raw-water pumping facilities were designed, including temporary electrical feeds, to ensure that minimum requirements could always be met.

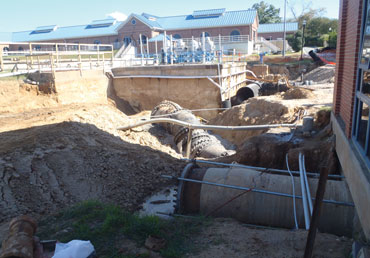

- Repair of failing stormwater tunnel beneath high-service yard piping: An in-situ external structural remediation plan was designed for the tunnel, which was set to be constructed as new piping was installed. However, once excavated, the tunnel was found to be in worse shape than anticipated. An expedited design of an alternate structural repair method was devised that consisted of an internal repair to the tunnel.
- Construction within the Canal waterway: Due to the potential presence of shortnose sturgeon in the Canal, no construction was permitted during the spawning season (March through June). A cofferdam had to be constructed to isolate the intake construction zone from the waterway so that construction could continue apace.
As a result of the close collaboration with Columbia and the development of detailed construction sequencing documents, there was no interruption of water service to customers served by the Canal WTP throughout the course of the project. The continuation of service was of particular importance, given that the Canal WTP provides water to approximately 375,000 customers, including three hospitals, the Westinghouse Nuclear Station, Fort Jackson, and McEntire Joint National Guard Base.
About the Author: Craig Metts is a senior project manager with URS Corporation (Columbia, S.C.), a leading provider of engineering, construction and technical services for public agencies and private sector companies around the world.
